Key milestone reached at Collector Wind Farm

A significant construction milestone at Collector Wind Farm was achieved this week with the first concrete poured into foundations in preparation for turbine towers to be installed next year.

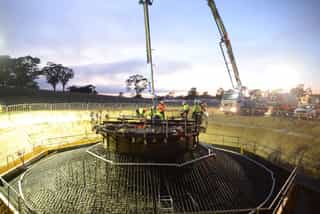

The project team worked for around eight hours to pour the 400 cubic metres of concrete required for the first of 54 foundations.

This  important step in the construction program was reached ahead of schedule and, depending on the weather, up to 15 foundation pours could be completed by Christmas.

Progress has been good since construction started in April and the 226MW wind farm is on course to be operational in early 2021.

Keep up to date with progress at the project website.

Decorator icons
Image Content

More news

$2.5 Million to communities across Australia Read More
10 year offtake agreement with ZEN Read More
We have just secured RATCH-Australia’s first “Green Financing Framework” Read More
Collector starts investing in local community Read More
Collector Wind Farm delivers first clean energy Read More
Site Logo

RATCH Australia Corporation acknowledges the Traditional Custodians of this country and pay our respect to Elders past, present and emerging.

RATCH Australia Corporation © All Rights Reserved - 2025 RATCH Australia
